Drilled, Driven, Screwed
This professional journey in the foundation industry began at an early age and includes roles such as welder, operator, foreman, estimator, project manager, engineer, management, director, and owner of a foundation company, leading to a specialist position at WSP. With over 25 years of experience as a contractor in deep foundations, there’s extensive expertise in managing projects from conception through completion.
As an engineer with a background in overseeing people, projects, and budgets, this experience allows for effective cost-saving strategies while generating business opportunities. The deep foundation industry is niche, but this diverse skill set allows clients to adapt structures and approaches within budget constraints while maintaining profitability.
Technical knowledge spans driven piles, drilled piles, caissons, various earth-retaining walls, slurry walls, cut-off walls, and soil improvement techniques. The complex assessment of factors such as soil conditions, equipment needs, and financial impacts of each technique is a core strength. This comprehensive experience ensures clients receive cost-effective and timely project guidance.
Piles are structural elements of a deep foundation system that are installed to transfer loads from a structure through weak or compressible surface soils to stronger, more stable soil or rock layers at depth. They are used when shallow foundations, such as spread footings or mats, are not feasible due to geotechnical constraints or structural demands.
The primary purpose of a pile is to develop load-carrying capacity through end-bearing (transferring loads directly onto a competent stratum) and/or skin friction (transferring loads via frictional resistance along the shaft of the pile). Piles are critical for resisting axial loads (compression and tension) as well as lateral loads, depending on the design criteria.
Common Reasons for Using Piles
Engineers may specify pile foundations in the following scenarios:
Types of Piles and Materials
Piles are generally classified based on material, installation method, and structural function:
By Material:
By Installation Method:
The selection of pile type and installation technique is governed by geotechnical investigation data, structural loading, environmental constraints, vibration or noise limits, and economic considerations.
Iconic Structures Supported by Pile Foundations
Many world-renowned structures rely on pile foundations due to their challenging site conditions or immense structural demands:
Conclusion
Pile foundations are indispensable in modern construction where ground conditions or structural demands exceed the capacity of conventional shallow foundations. By transferring loads to deeper, more stable strata, piles ensure the safety, serviceability, and durability of critical infrastructure. Their design and implementation require careful coordination between geotechnical, structural, and construction disciplines to address both engineering performance and constructability. As urbanization and infrastructure development continue to push the limits of design and site adaptability, pile systems remain at the core of reliable and resilient foundation engineering.
underlying soils and site constraints and property lines. There are several different types that exist, and their installations also vary along with sometimes their materials. Piles can be made from wood, steel, concrete and a composite of both steel and concrete. They can be driven into the ground, drilled, screwed, and pushed hydraulically. The selection of the material and installation varies often due to site conditions and underlying soil stratums.

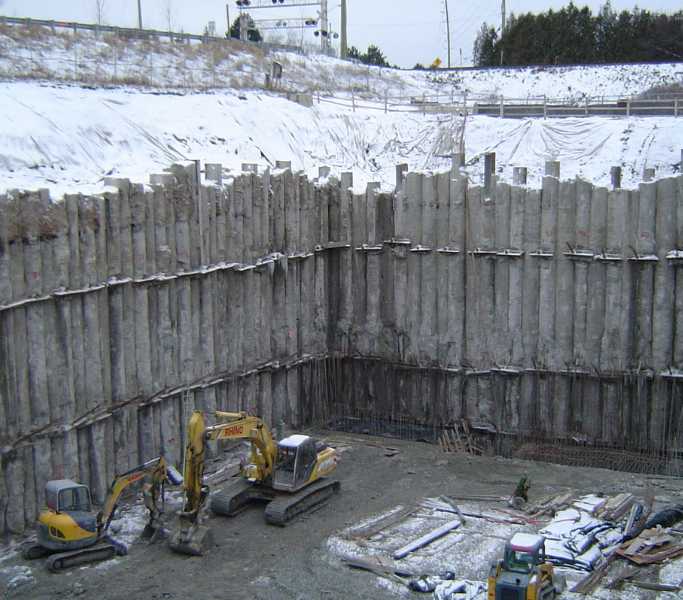

Caissons are deep foundation elements that are typically constructed by drilling a large-diameter shaft into the ground and then filling it with reinforced concrete. They are often referred to as drilled shafts or bored piles, although in technical practice, caissons usually imply larger diameters and a higher degree of structural complexity.
Unlike driven piles, which are installed by impact or vibration, caissons are formed by excavation and allow for precise placement and control, making them well-suited for urban or sensitive environments where vibration must be minimized.
Key Characteristics of Caissons
Differences Between Caissons and Piles
Feature | Caissons | Piles |

Installation Method | Drilled, excavated, then cast in place | Driven, drilled, screwed, or jacked |
Diameter | Generally large (1–3+ meters) | Smaller (typically <1 meter) |
Material | Reinforced concrete only | Concrete, steel, timber, or composite |
Load Capacity | Very high axial and lateral resistance | Varies depending on type and installation |
End Condition | Often socketed into bedrock | May be friction piles, end-bearing, or both |
Construction Control | Allows full inspection before concreting | Less visible control—must rely on driving logs |
Vibration / Noise | Minimal (ideal in urban zones) | Can be high (especially for driven piles) |
Common Use | Bridges, towers, heavy infrastructure | Buildings, retaining walls, lighter structures |
Conclusion
While both caissons and piles serve the purpose of transferring structural loads to deeper, more stable layers, caissons are distinguished by their larger size, construction technique, and load-carrying potential. Their ability to be socketed into rock and to resist significant lateral forces makes them a preferred choice for critical and high-load structures. However, caissons are generally more expensive and time-consuming to construct, requiring specialized equipment and site conditions that accommodate large-scale drilling and concreting operations.

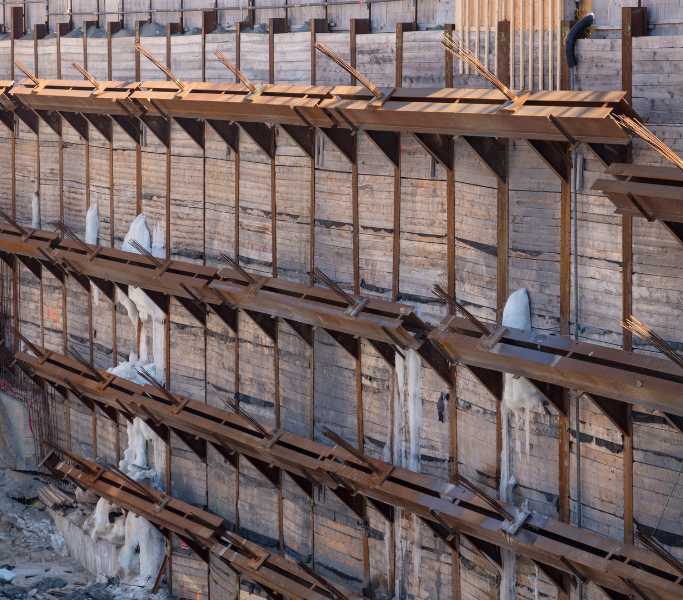

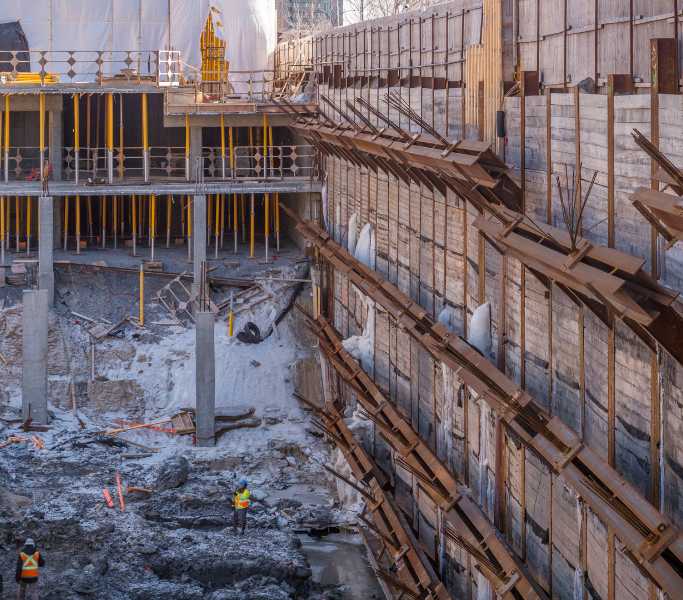

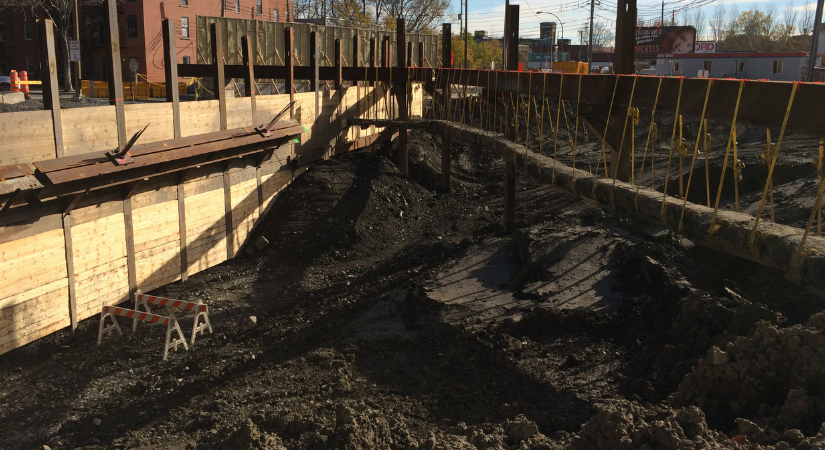

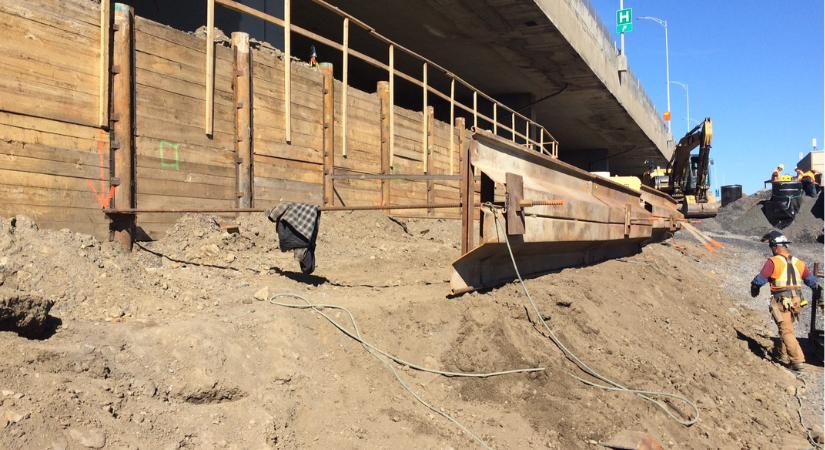

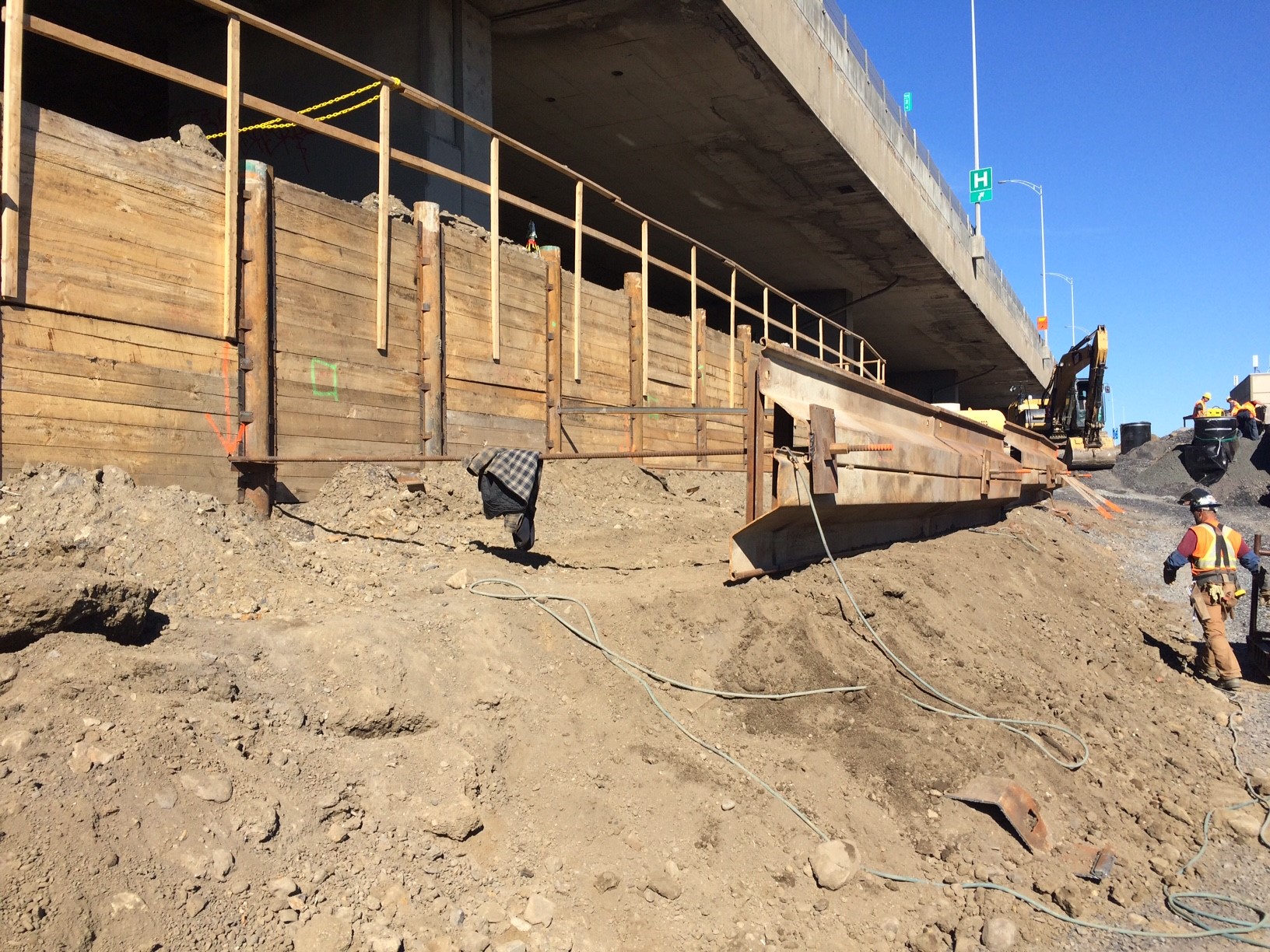

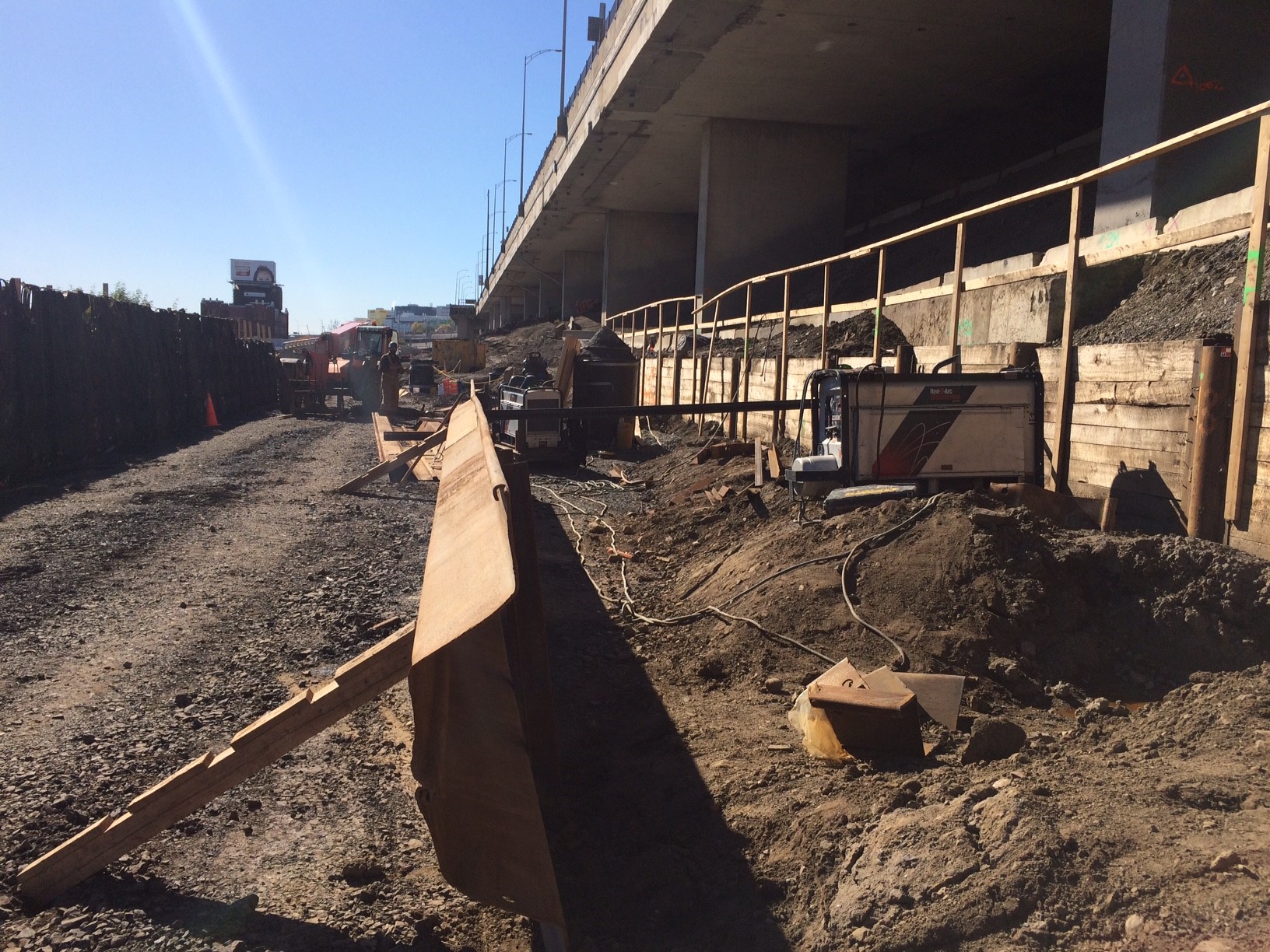

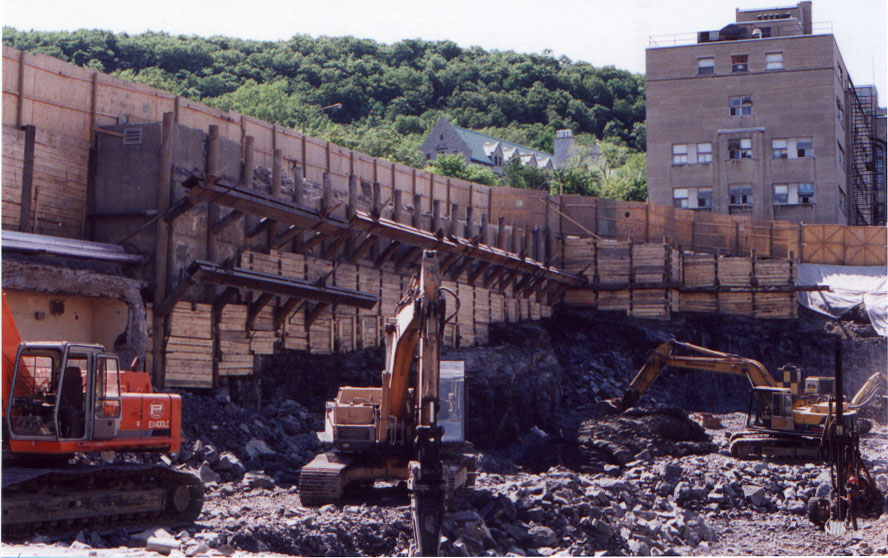

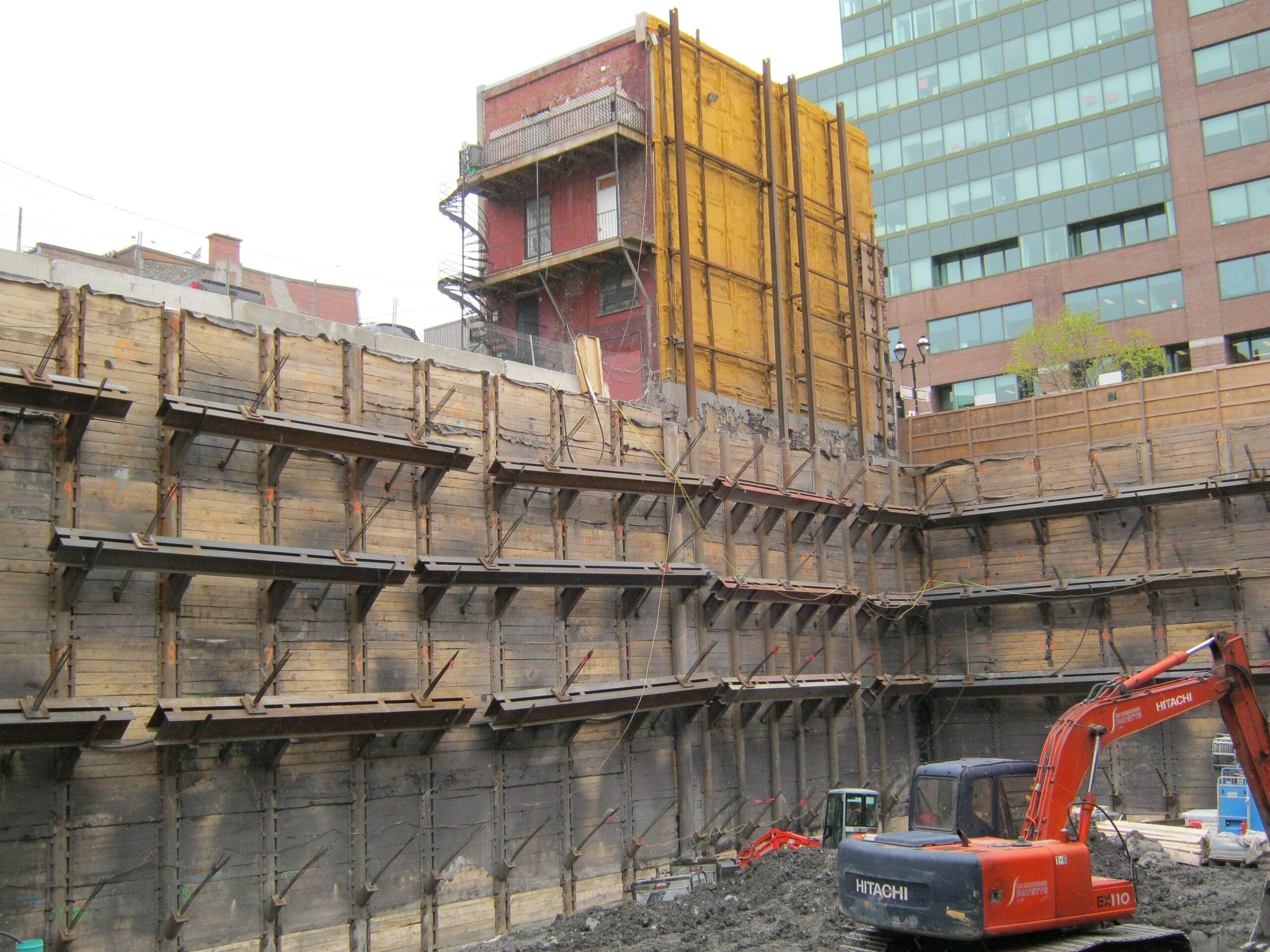

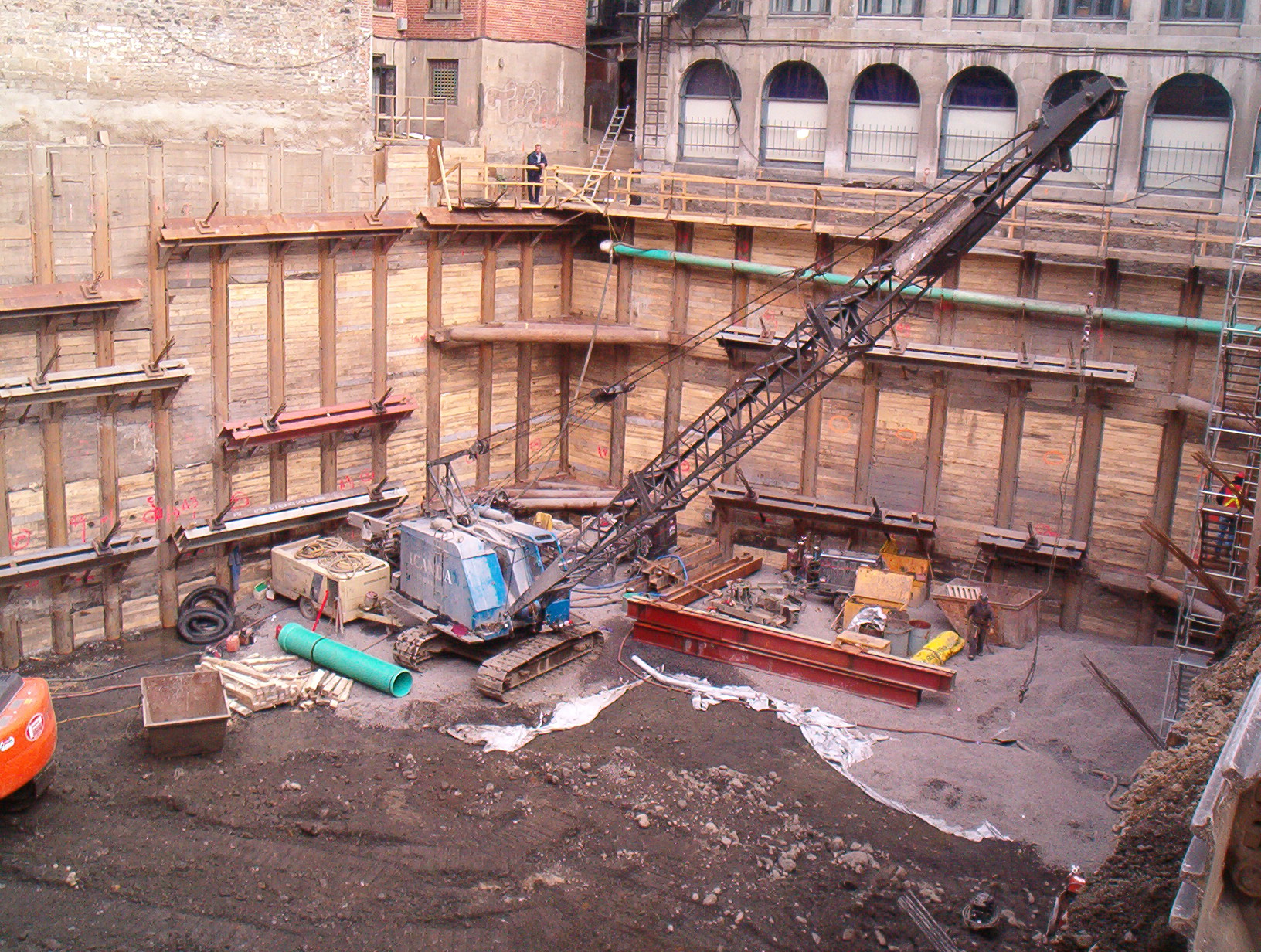

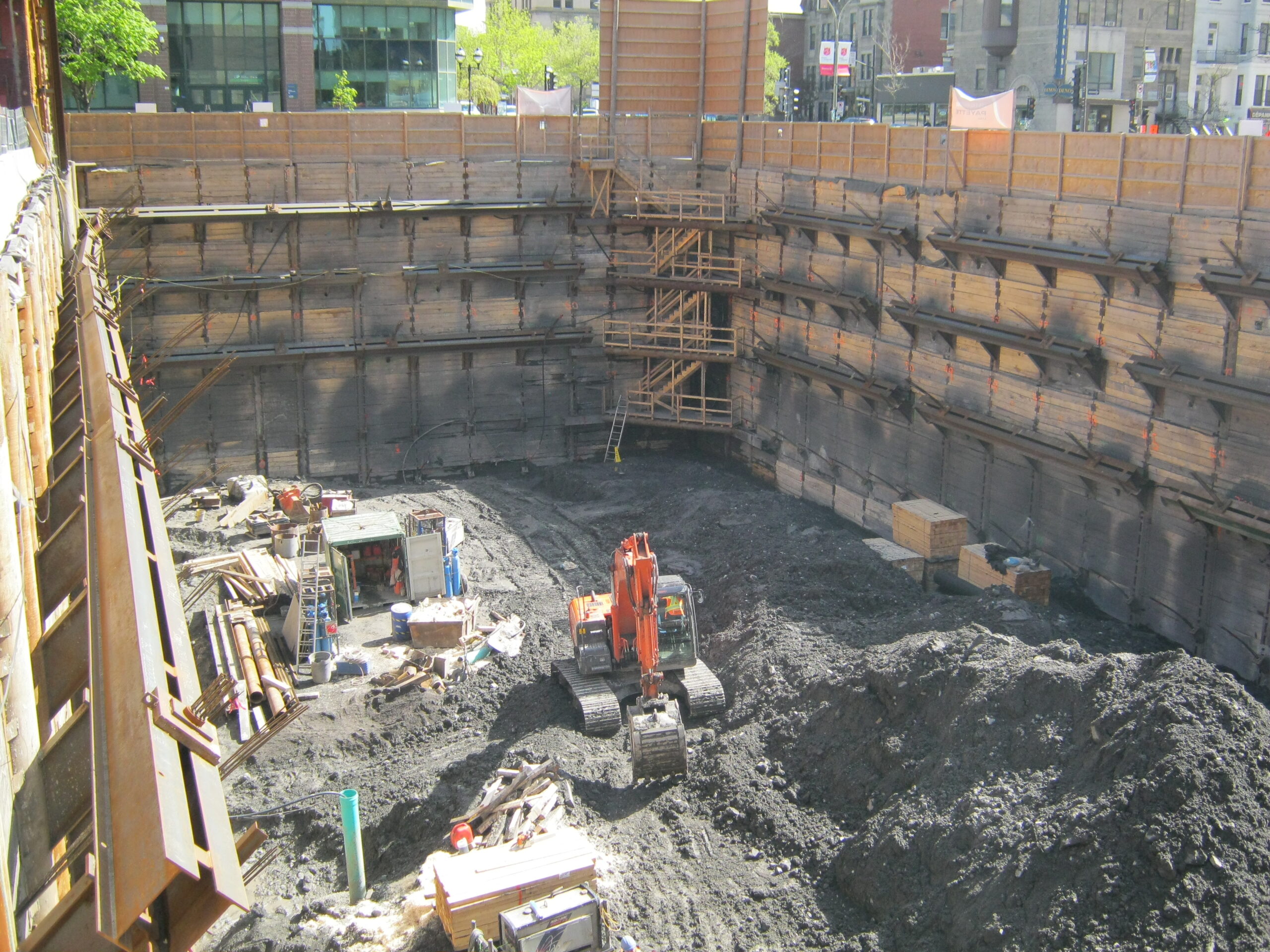

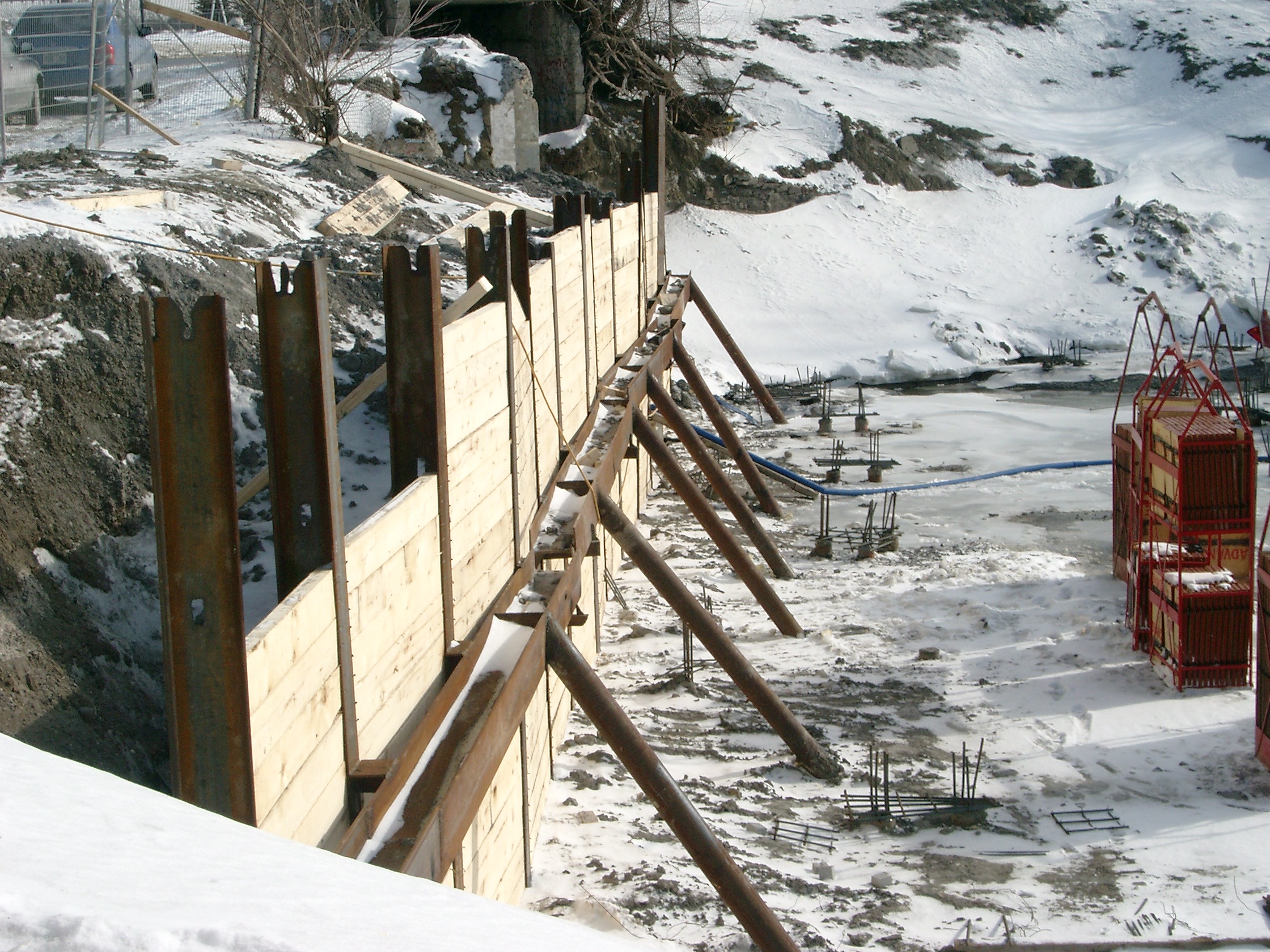

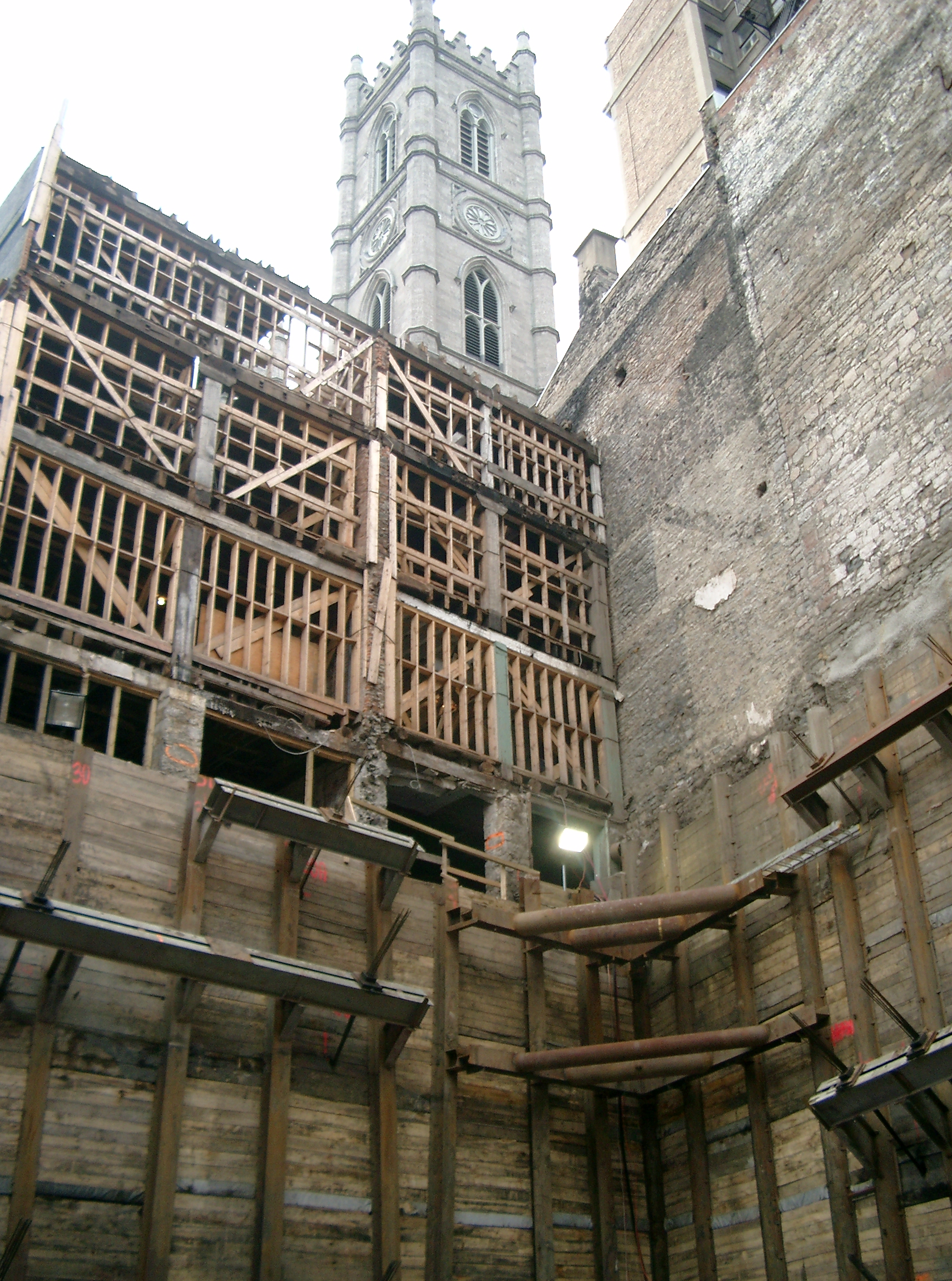

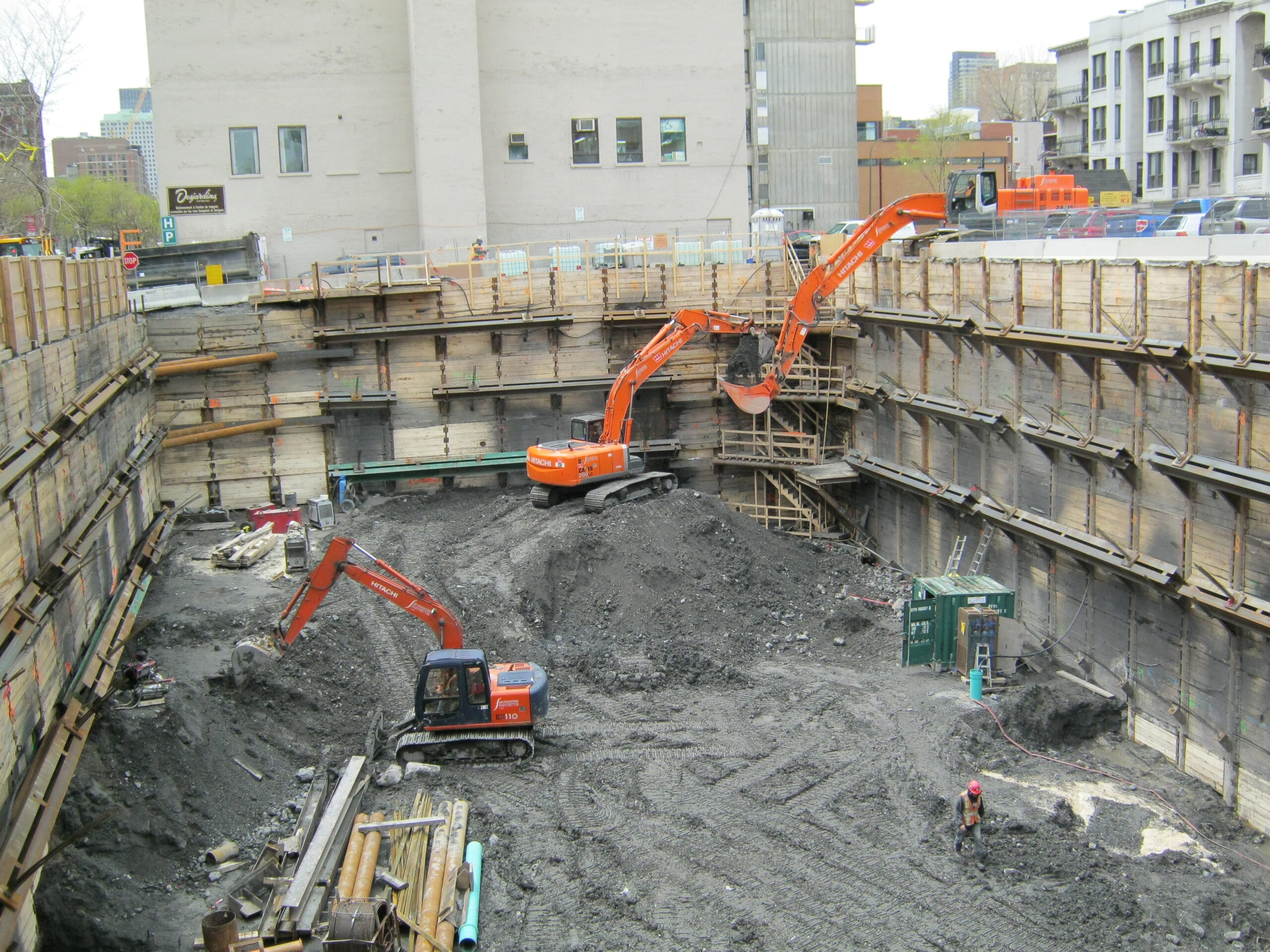

Berlin walls, also known as soldier pile and lagging walls, are among the most commonly used temporary or semi-permanent retaining systems in urban excavation projects. Their widespread popularity stems from their versatility, cost-effectiveness, and adaptability to various site conditions.
Advantages of Soldier Pile and Lagging Systems
Lagging Materials and Cost Considerations
The use of timber lagging between soldier piles provides a significant cost advantage over systems that rely on precast concrete or steel sheeting. While wood is not permanent and may deteriorate over time, it is sufficient for temporary applications and easy to replace or reinforce when needed.
Limitations and Considerations
Despite their popularity, soldier pile and lagging systems are not suitable in all conditions:
Conclusion
Soldier pile and lagging walls (Berlin walls) are popular due to their constructability, flexibility, and cost-effectiveness in a wide variety of soil and site conditions. They provide an efficient and reliable solution for temporary excavations and are a preferred choice for many urban infrastructure and building projects. However, engineers must remain cautious of their limitations in groundwater control and deflection management, especially near critical or sensitive infrastructure. Proper geotechnical investigation and wall design are essential to ensure performance and safety.

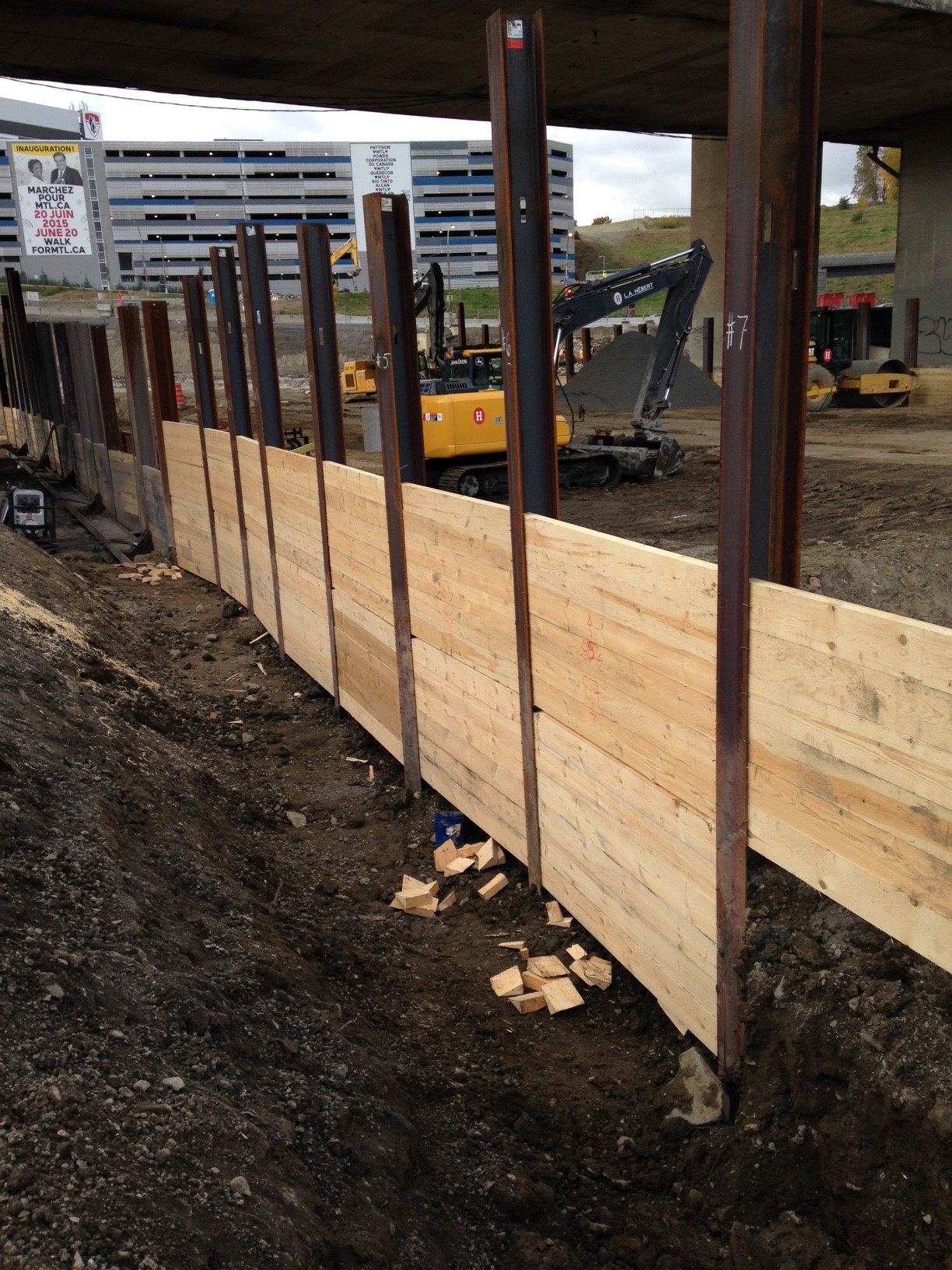

1. Soldier Pile and Lagging Walls (Berlin Walls)
Overview:
Soldier pile and lagging systems consist of vertical steel H-piles installed at regular intervals, with horizontal lagging elements (typically timber or precast panels) placed between the piles as excavation progresses.
Advantages:
Limitations:

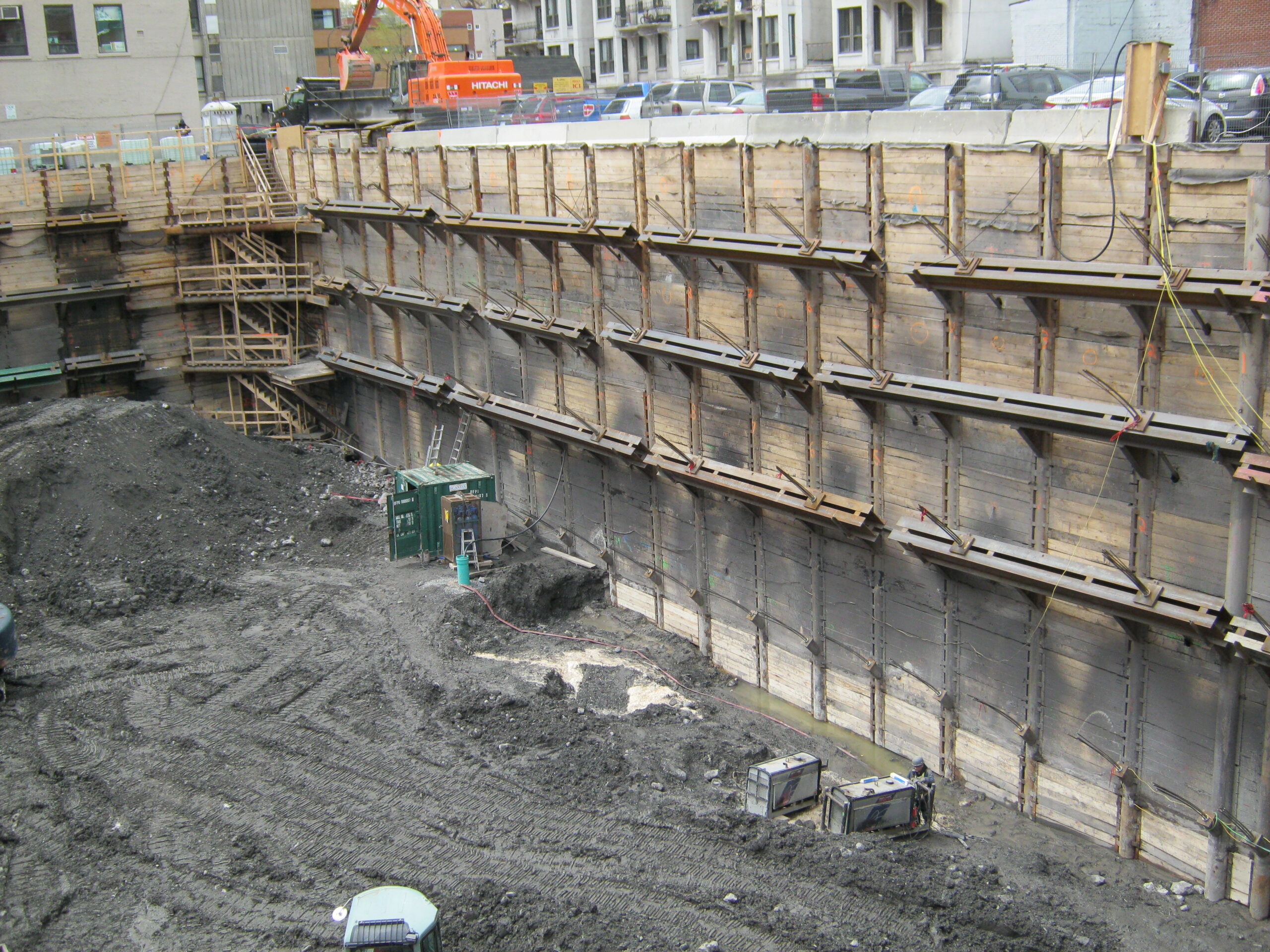

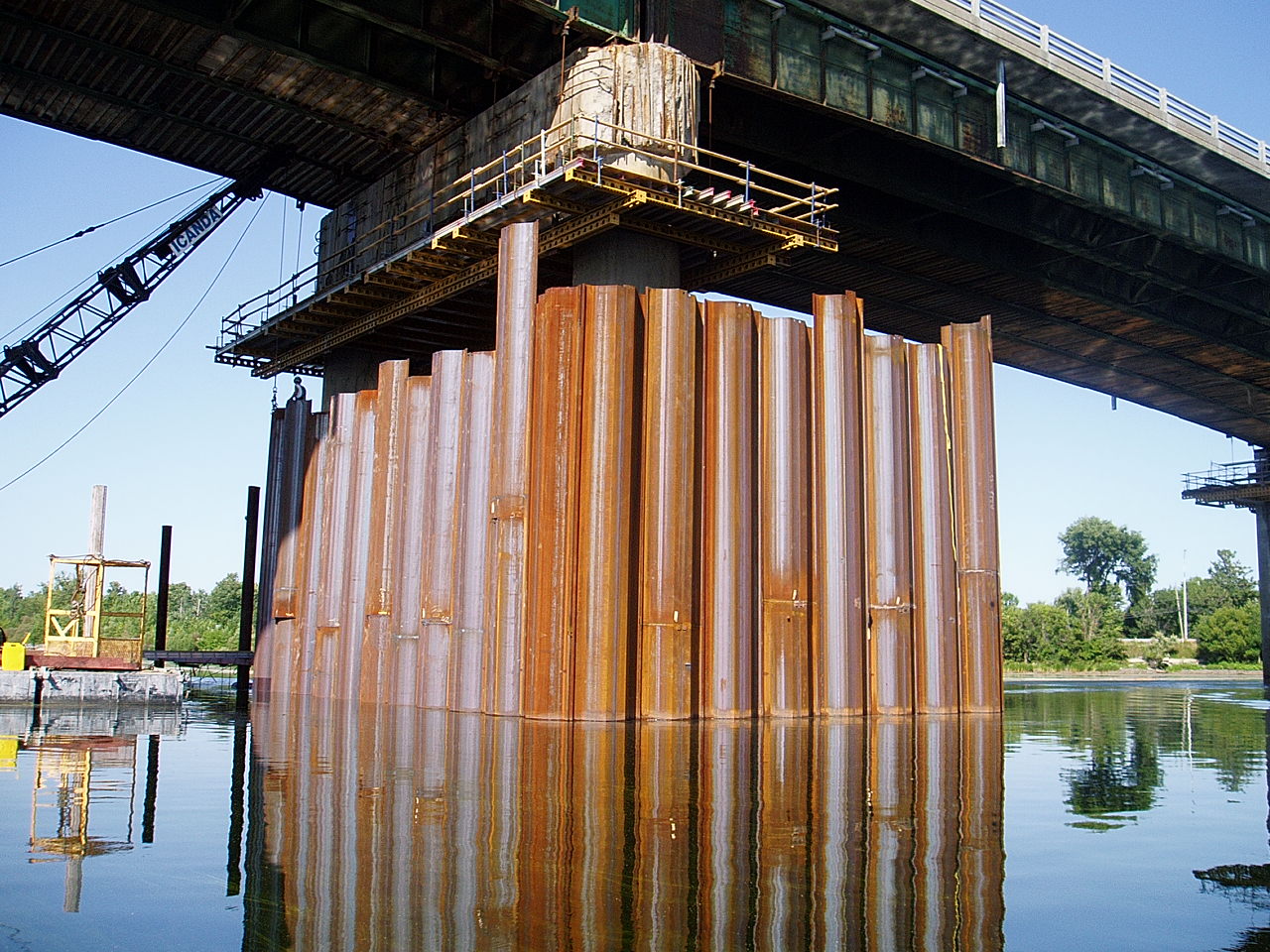

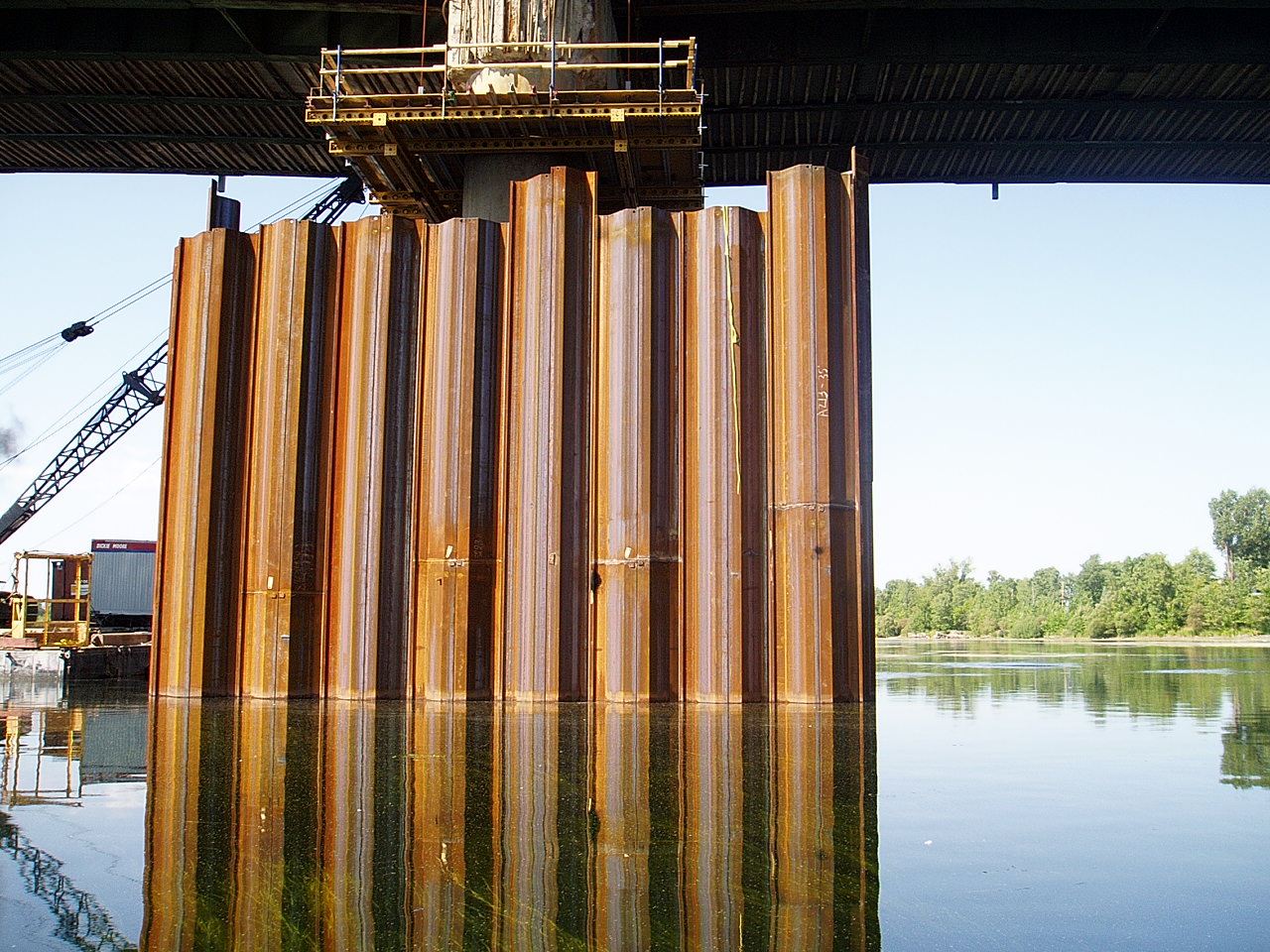

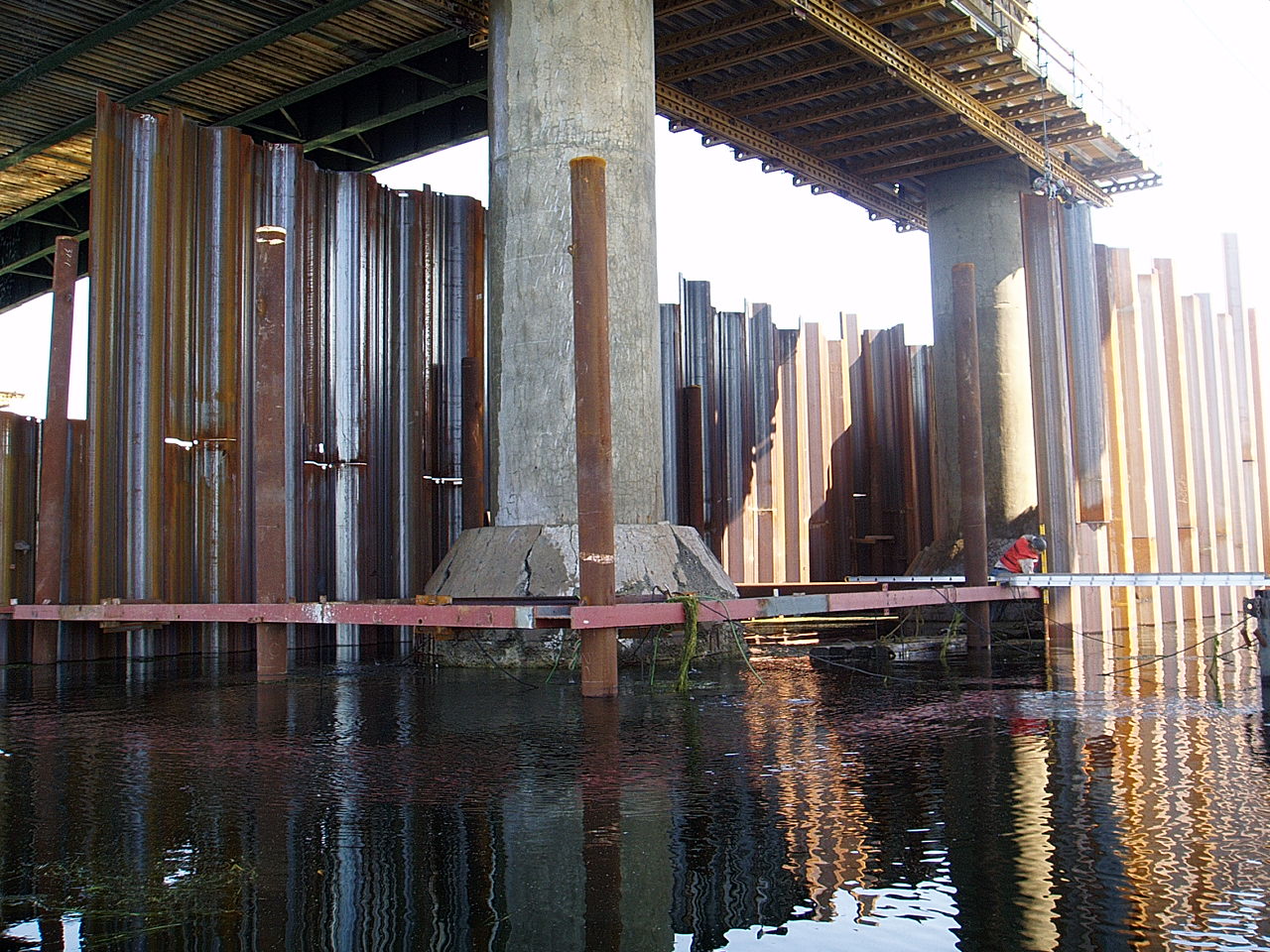

2. Sheet Pile Walls
Overview:
Sheet piles are interlocking steel sections driven into the ground to form a continuous vertical wall. They are often used in marine environments or where water cutoff is required.
Advantages:
Limitations:

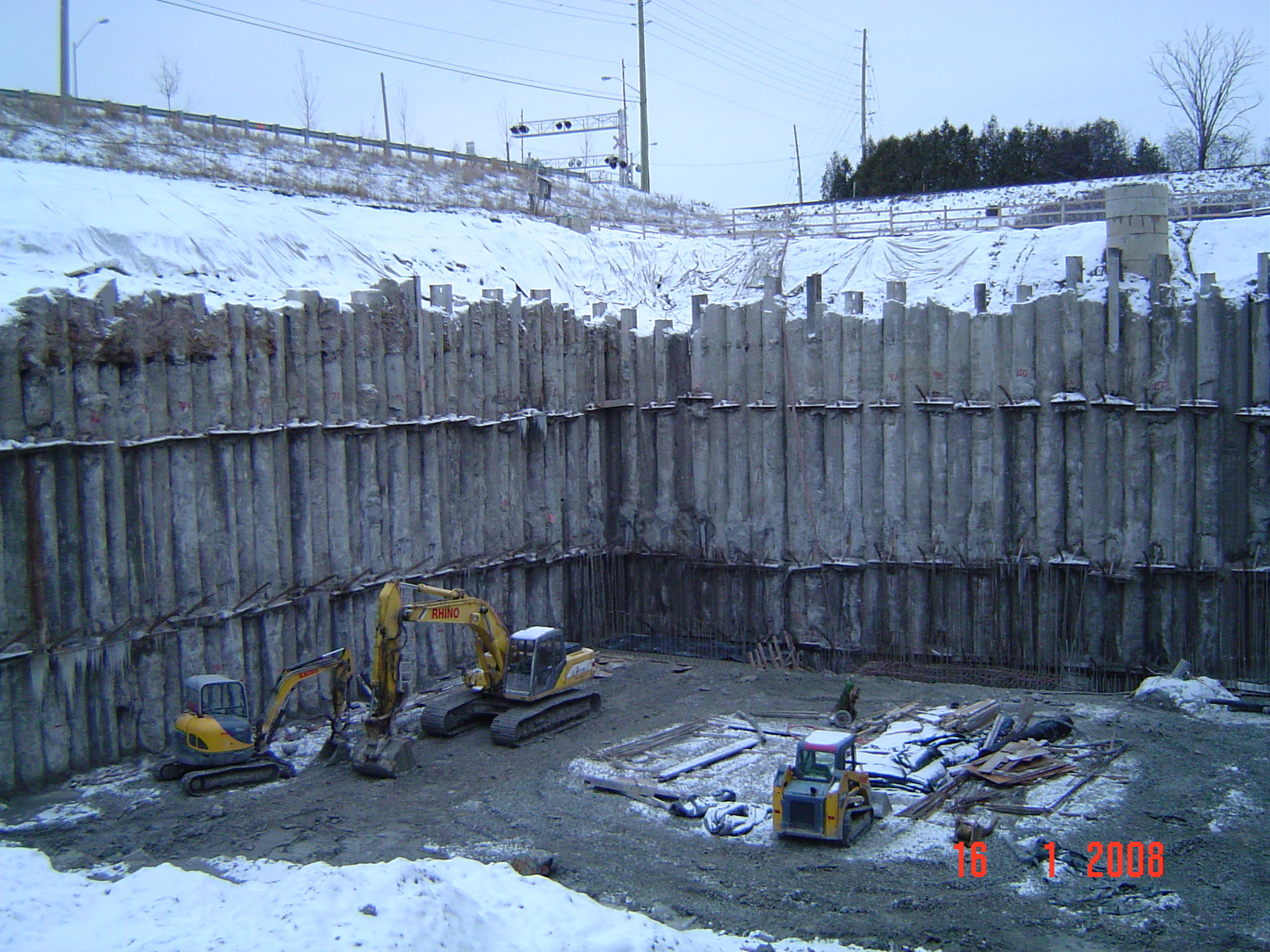

3. Secant Pile Walls
Overview:
Secant pile walls consist of overlapping concrete piles (alternating soft and hard piles), forming a continuous wall. Reinforced piles provide structural support; unreinforced piles offer water cutoff.
Advantages:
Limitations:

4. Diaphragm Walls (Slurry Walls)
Overview:
Diaphragm walls are constructed by excavating a trench in slurry (usually bentonite), then filling it with reinforced concrete. These walls are continuous and typically very thick.
Advantages:
Limitations:
5. Soil Nail Walls
Overview:
Soil nails are passive reinforcement elements installed in the soil and combined with a facing system (e.g., shotcrete) to stabilize excavated slopes.
Advantages:
Limitations:
6. Tangent Pile Walls
Overview:
Tangent piles are constructed similarly to secant piles but do not overlap. This creates a continuous but non-waterproof wall of adjacent concrete piles.
Advantages:
Limitations:
Summary Table – Retaining System Comparison
System | Cost | Stiffness | Water Tightness | Noise/Vibration | Constructability | Use Case |
Soldier Pile & Lagging | Low | Low–Medium | Poor | Low (if drilled) | Simple, fast | Temporary works, urban sites |
Sheet Piles | Medium | Medium | Moderate–Good | High | Fast in soft soils | Marine, flood protection, water control |
Secant Pile Walls | High | High | Excellent | Low | Complex, precise | Deep, watertight, permanent applications |
Diaphragm Walls | Very High | Very High | Excellent | Very Low | Equipment intensive | Large-scale basements, high-rise cores |
Soil Nail Walls | Low–Medium | Medium | Poor | Very Low | Adaptable, staged | Cut slopes, temporary shoring |
Tangent Pile Walls | Medium–High | High | Poor | Low | Less complex than secants | Semi-permanent walls, dry conditions |
Conclusion
The choice of retaining wall system depends on multiple factors, including soil conditions, groundwater table, structural requirements, space limitations, budget, and construction timeline. Soldier pile and lagging walls remain a top choice due to their economy, simplicity, and adaptability, especially in temporary excavations in urban environments. However, more robust or watertight systems such as secant piles or diaphragm walls are essential where deep excavations, minimal movement, or groundwater control are critical.
A comprehensive geotechnical investigation, paired with structural modeling and a clear understanding of project constraints, is essential for selecting the optimal shoring system.
While sheet piles are a cost-effective and commonly used shoring system for temporary and permanent excavations, they are not always a viable solution, especially in challenging ground conditions. In such cases, secant pile walls, although more expensive, offer technical advantages that can justify their selection.
Limitations of Sheet Piles
Sheet piles are typically installed by driving or vibrating interlocking steel sheets into the ground. While fast and economical in soft or medium soils, their effectiveness is limited in certain conditions:
Advantages of Secant Pile Walls
Secant pile walls are constructed using overlapping drilled concrete piles, often alternating between primary (unreinforced) and secondary (reinforced) piles. Their drilled construction method and continuous configuration offer several key advantages:
Conclusion
Although secant pile walls involve higher upfront costs due to their material requirements, drilling precision, and longer construction time, they offer superior performance in geotechnically complex environments where sheet piles are not feasible.
In projects involving:
secant walls provide a reliable, low-risk, and structurally robust solution, often reducing long-term project risk and costs associated with dewatering, ground movement, or remediation.
Slurry walls, also known as diaphragm walls, are the most expensive type of retaining wall because they serve a dual function: they act as both soil retention structures during excavation and as structural walls that support the building.
Advantages of Slurry Walls
Why Are Slurry Walls Not More Widely Used?
Conclusion
Slurry walls represent a state-of-the-art engineering solution ideal for projects demanding high performance in groundwater control, structural capacity, and space optimization in urban settings. However, due to their high cost and complex installation, their use is generally reserved for large-scale or particularly challenging projects such as high-rise buildings, underground parking garages, or infrastructure with stringent geotechnical requirements.

The primary driver behind selecting soil improvement techniques over deep foundation systems such as piles is cost efficiency. When site conditions are favorable, enhancing the existing soil’s bearing capacity and stiffness is often more economical and practical than installing costly deep foundations.
Key Considerations for Soil Improvement
These techniques work by increasing the effective stress in the soil, improving drainage characteristics, and creating a more uniform and stable platform for foundation support.
Benefits of Soil Improvement
Limitations and Risks
Conclusion
Soil improvement methods provide an economical and effective alternative to deep foundations when soil conditions and structural demands allow. By enhancing the existing ground to form a stiff and stable platform, they enable the use of conventional shallow foundations, thus reducing project costs and complexity.
A variety of ground improvement techniques exist, including compaction methods, continuous flight auger (CFA) piles, stone columns, and soil inclusions. The decision to select one technique over another is primarily governed by site-specific ground conditions, structural load requirements, and material and installation costs, which can vary significantly depending on geographic location and project specifics.
Key Considerations
Summary
While several soil improvement options exist, the choice between stone columns and inclusions often hinges on balancing soil conditions, structural demands, and cost considerations. Stone columns are generally more cost-effective in suitable soils and moderate loading scenarios, whereas inclusions are favored for increased stiffness, lateral load resistance, or more demanding geotechnical challenges.
Similarities:
Both slurry walls and slurry trenches use slurry (usually bentonite or polymer-based fluids) during their construction to support the excavation walls temporarily and prevent collapse before backfilling or concreting. This common step in construction often leads to confusion between the two.
Slurry Walls:
Slurry Trenches:
Summary Table
Feature | Slurry Walls | Slurry Trenches |
Function | Structural retaining walls | Non-structural groundwater barriers |
Load-bearing capacity | High (supports buildings/structures) | None (no structural loads) |
Construction method | Excavation stabilized by slurry, reinforcement cage inserted, then concreted | Excavation stabilized by slurry, backfilled with impermeable materials |
Typical materials | Reinforced concrete | Soil-cement, bentonite, polymers, or in situ soil |
Typical applications | Foundation walls, basements | Groundwater cutoff, contaminant containment |
